BHUBANESWAR

Status:
  • Contract for removing existing pipe lines at site has been signed, and work is likely to commence shortly. (12 Dec 11)
  • Revised schedule of installment : 19 Oct 11. more...

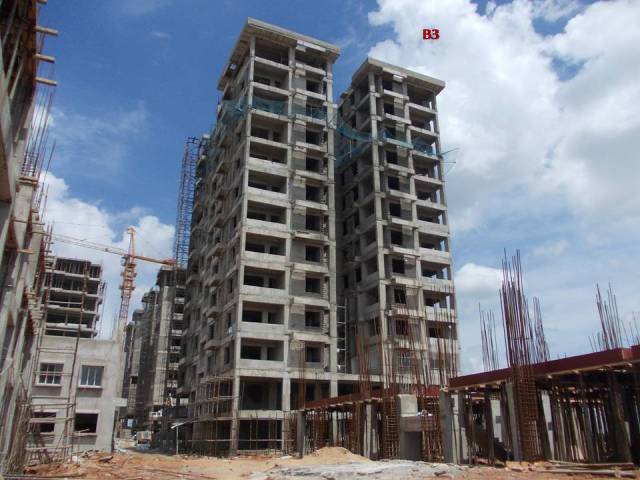

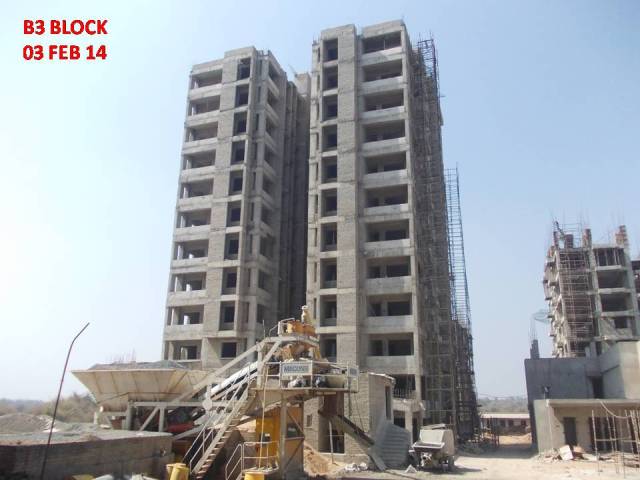

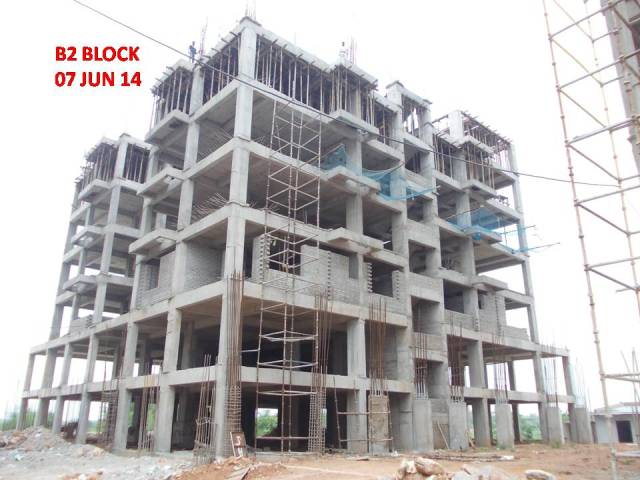

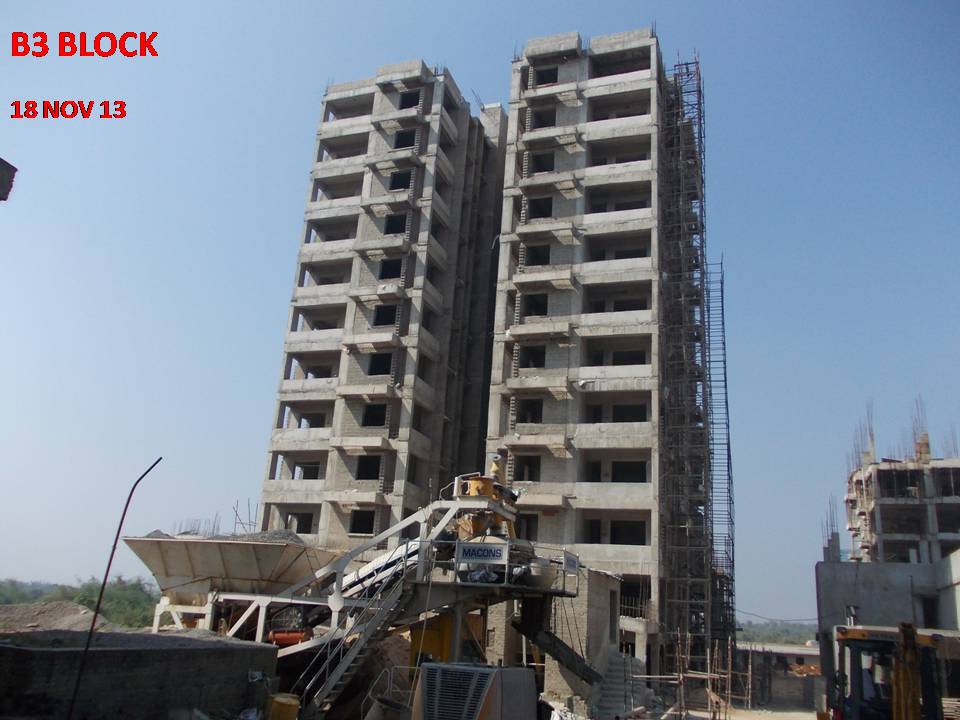

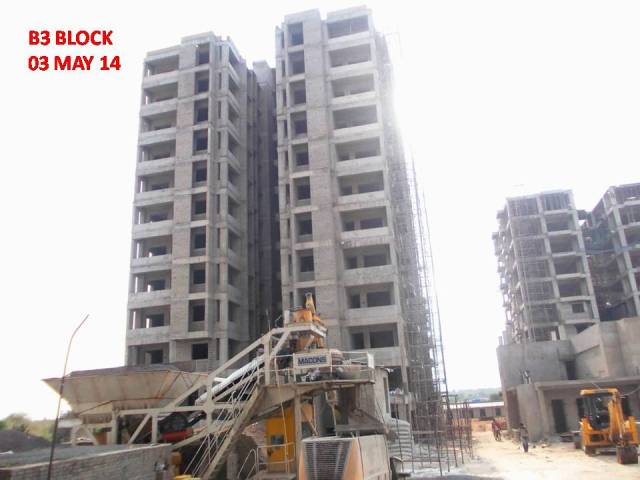

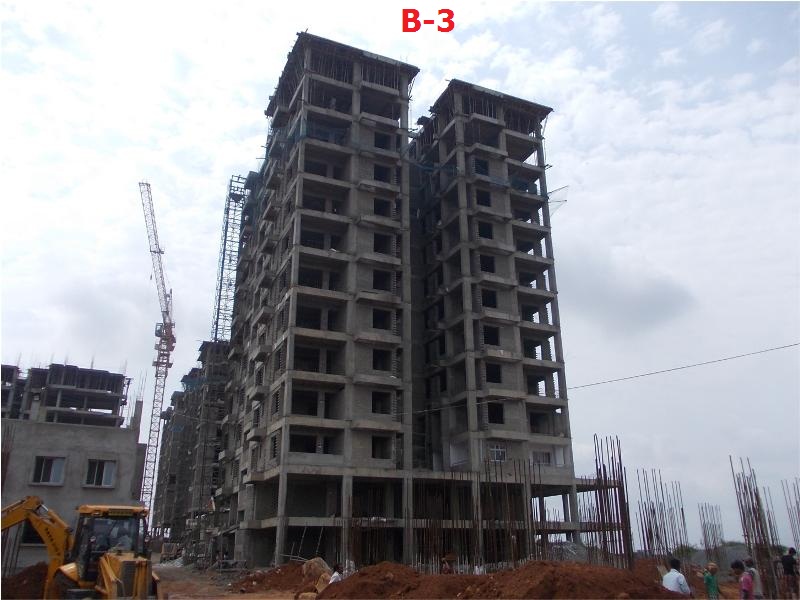

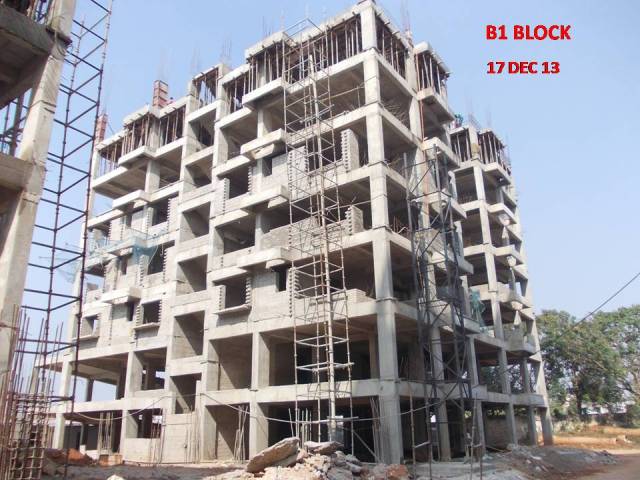

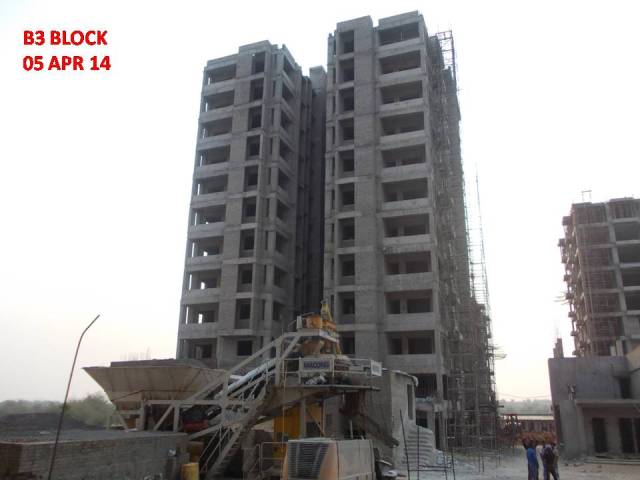

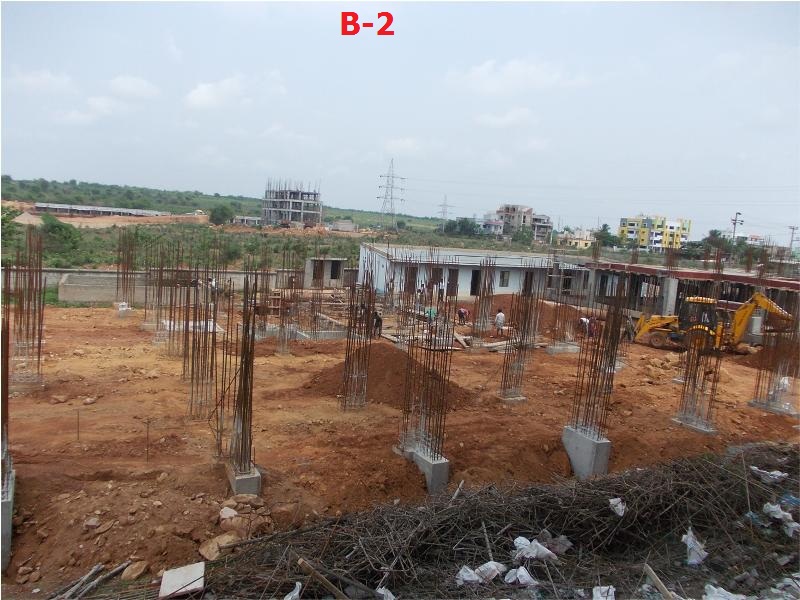

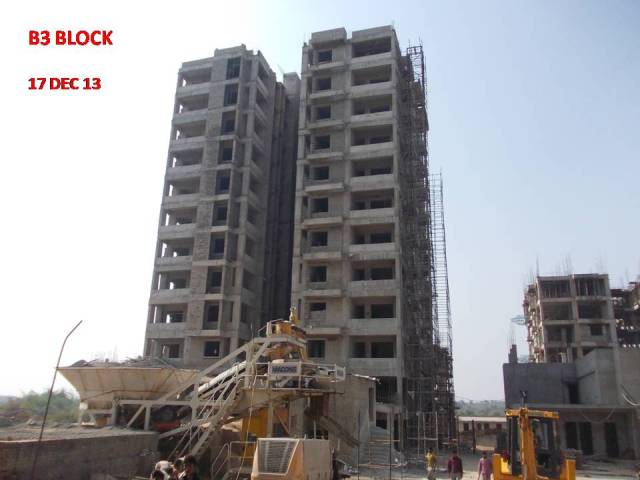

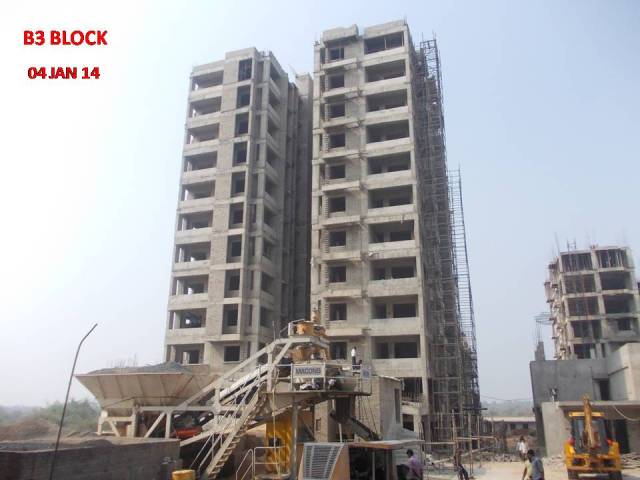

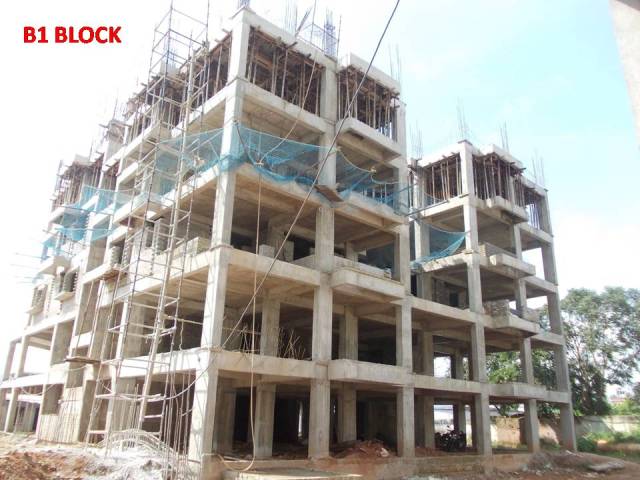

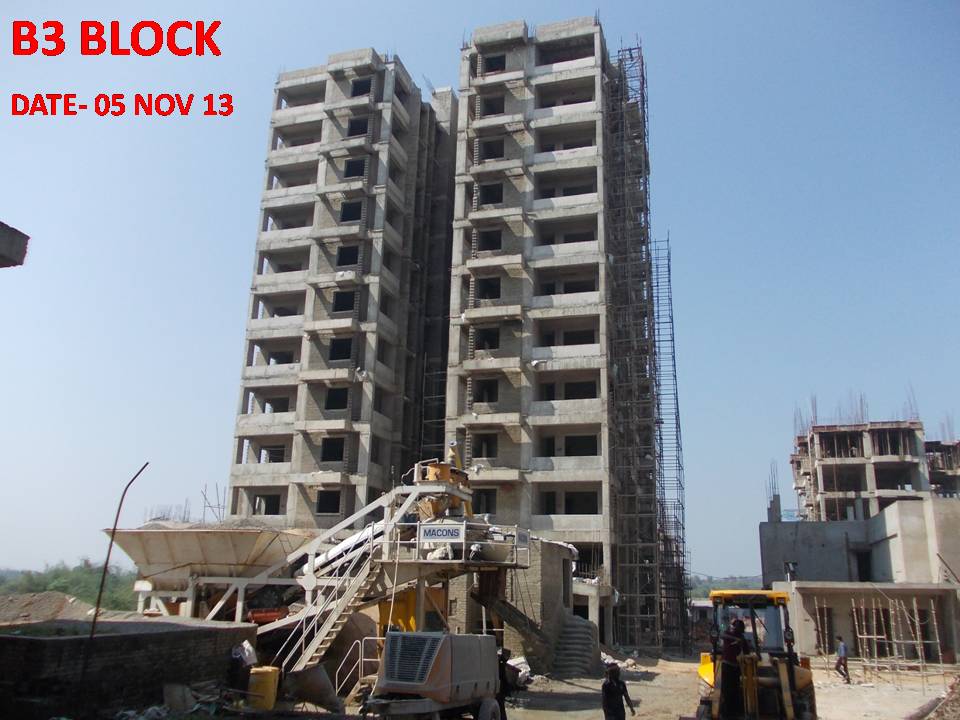

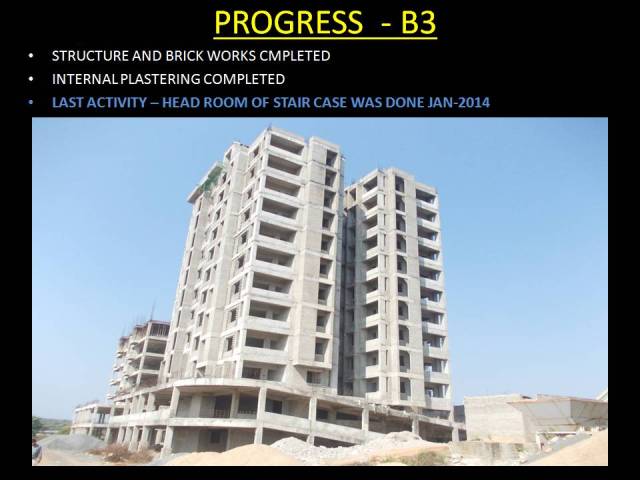

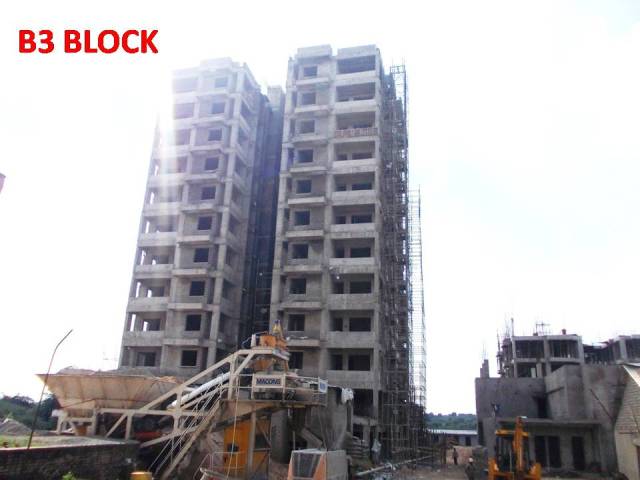

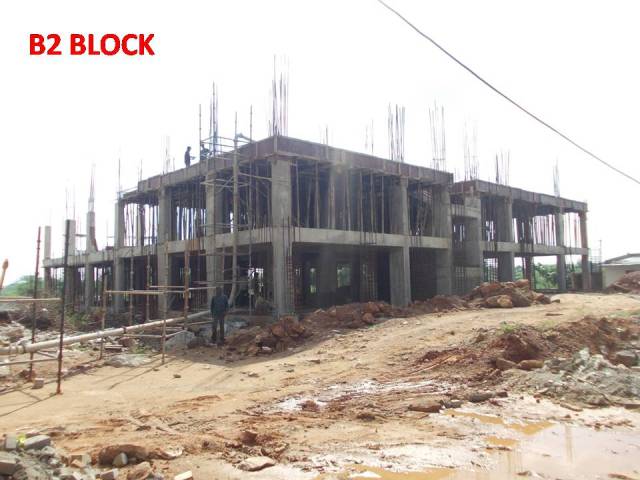

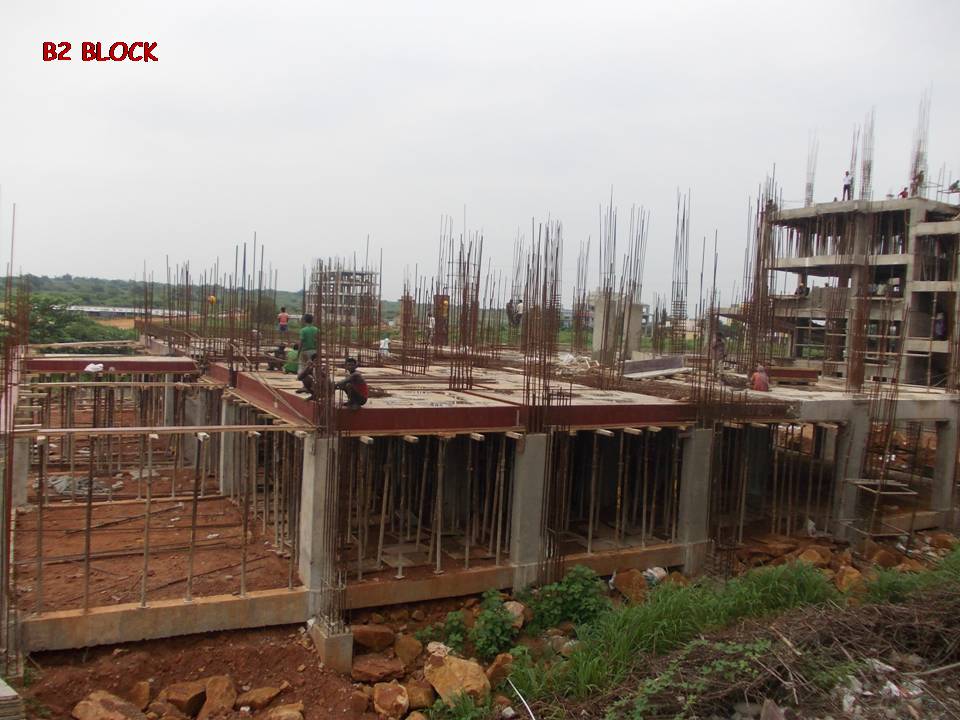

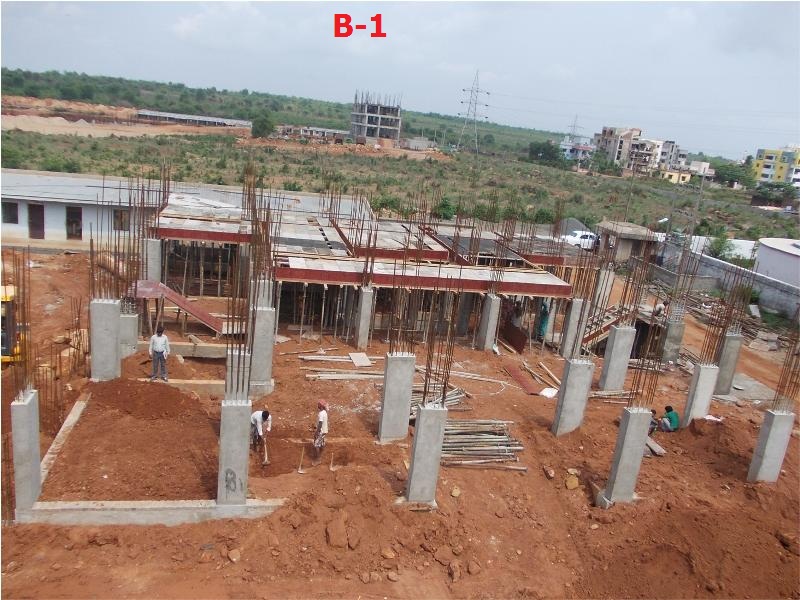

  • Plinth Beam of B-3 block started.

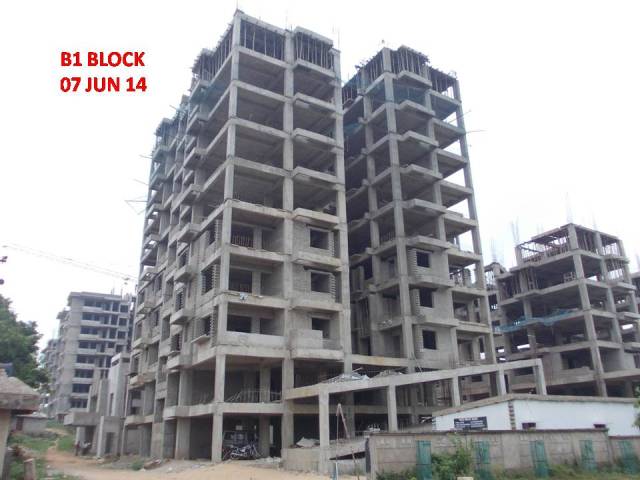

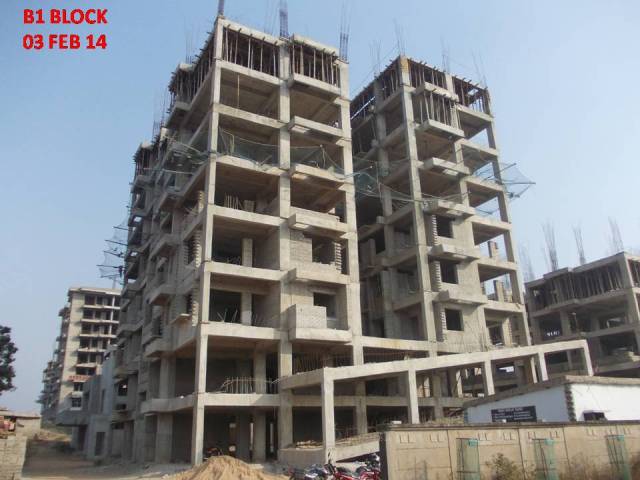

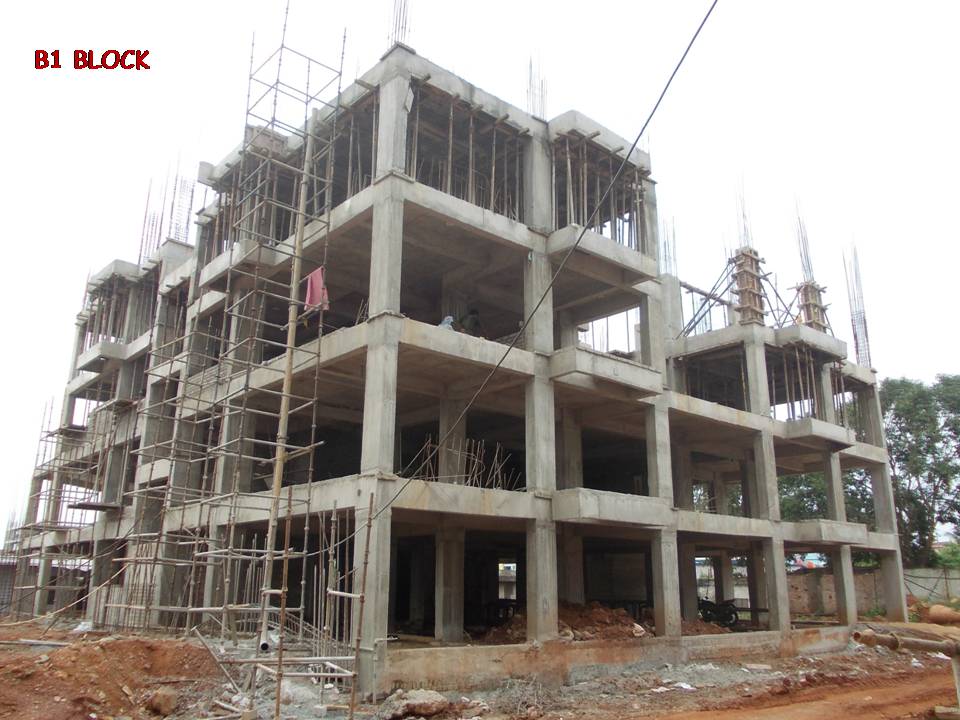

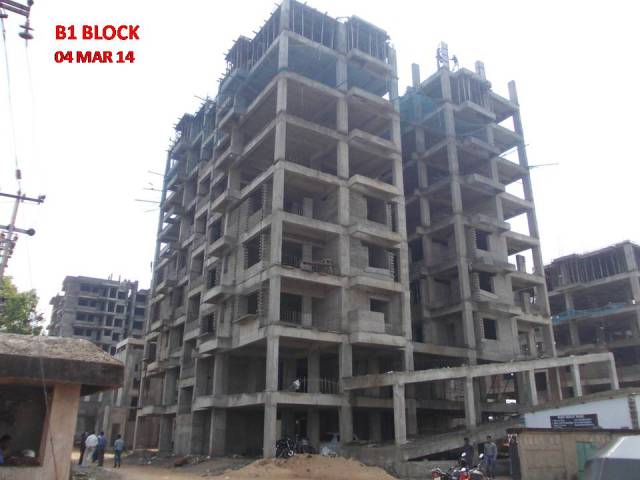

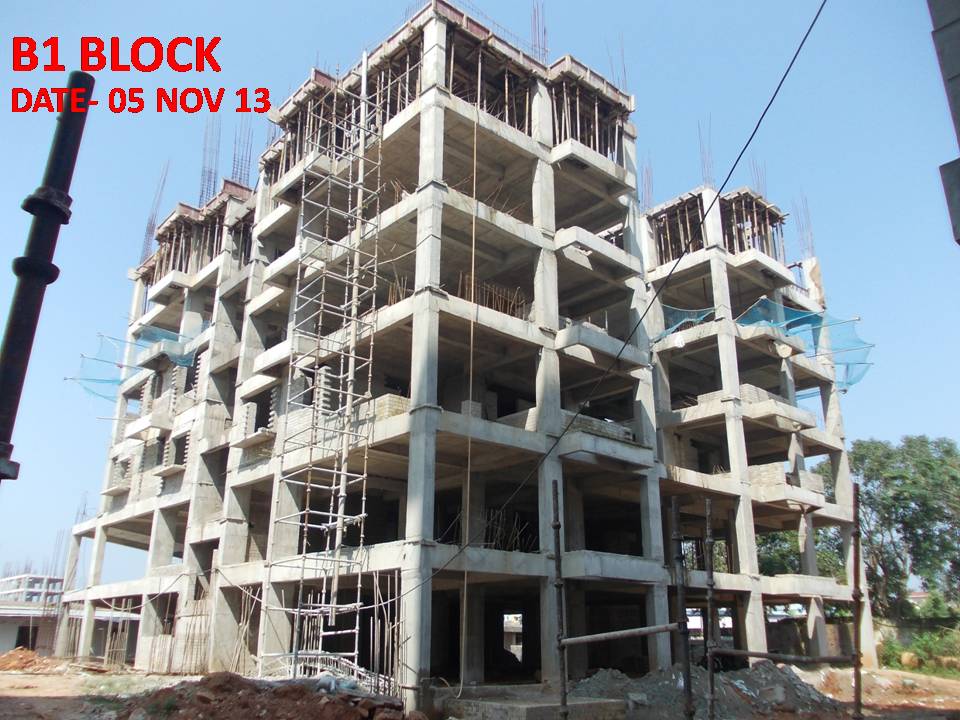

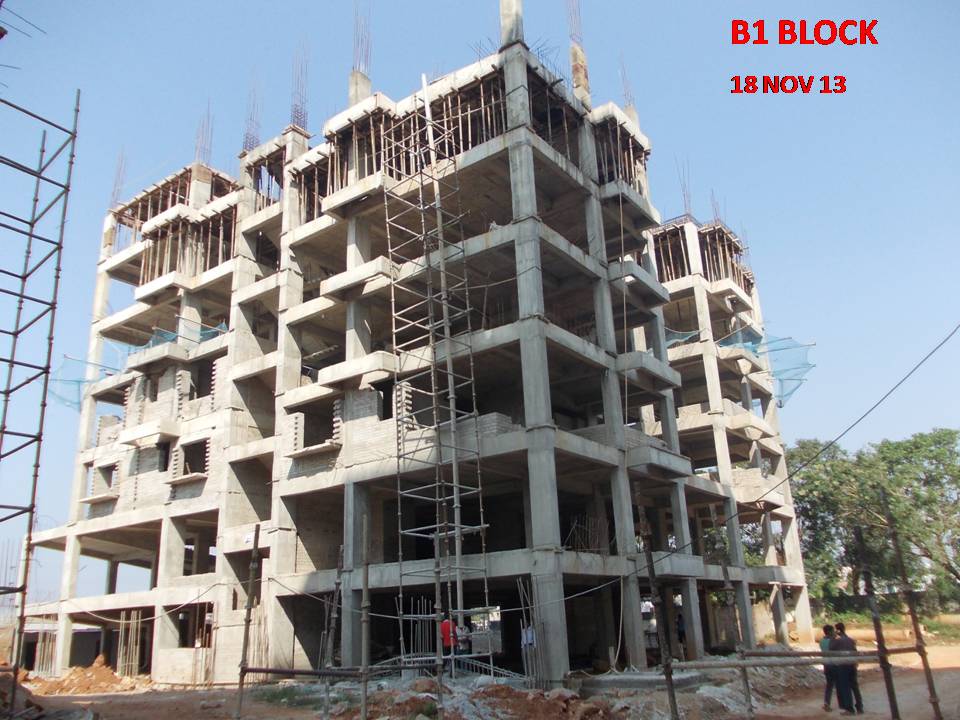

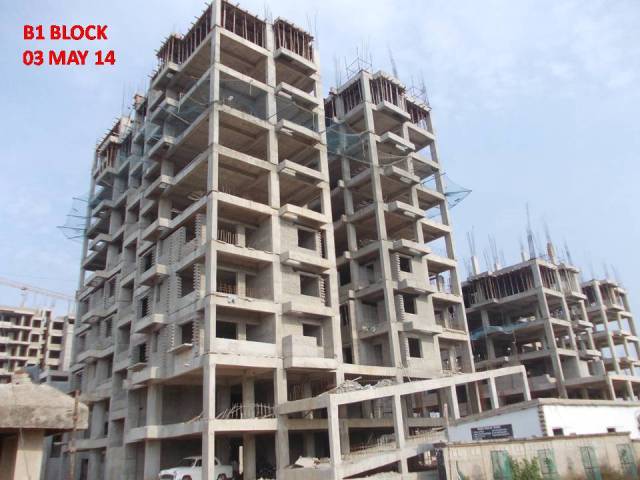

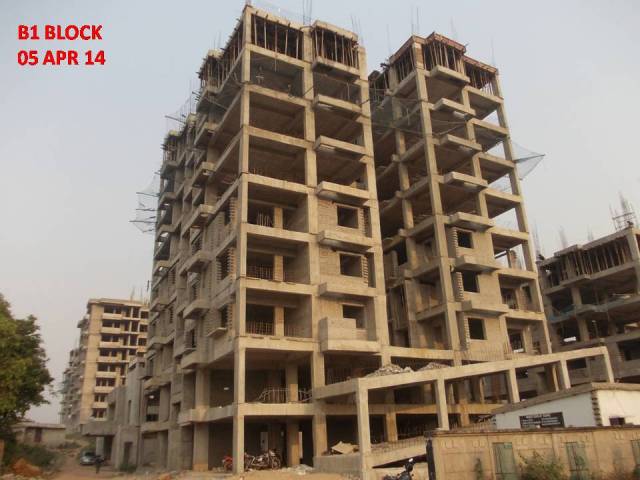

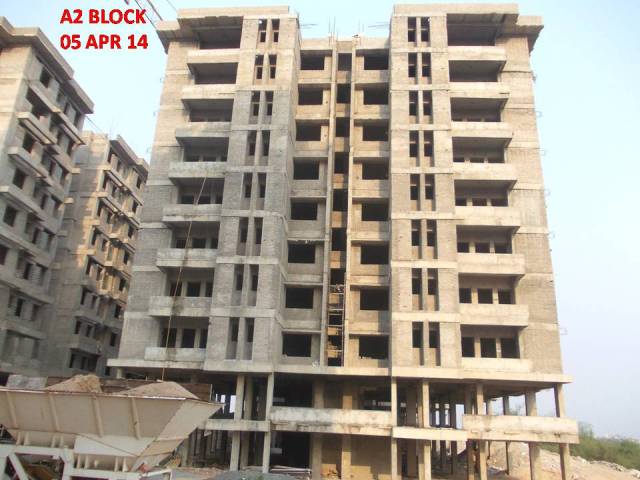

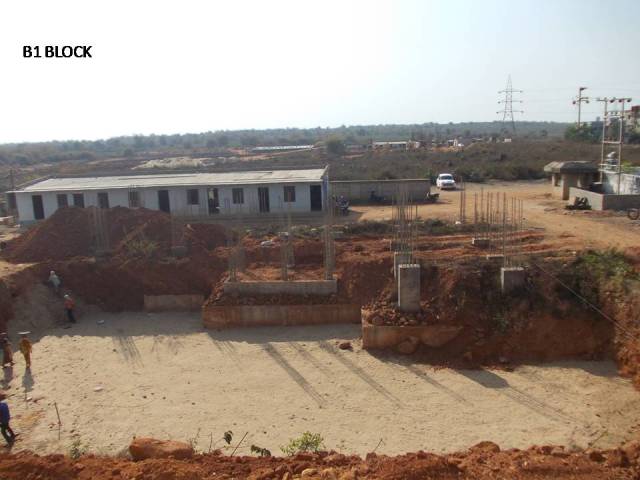

  • Footing and columns till plinth beam of B-1 block partially completed.

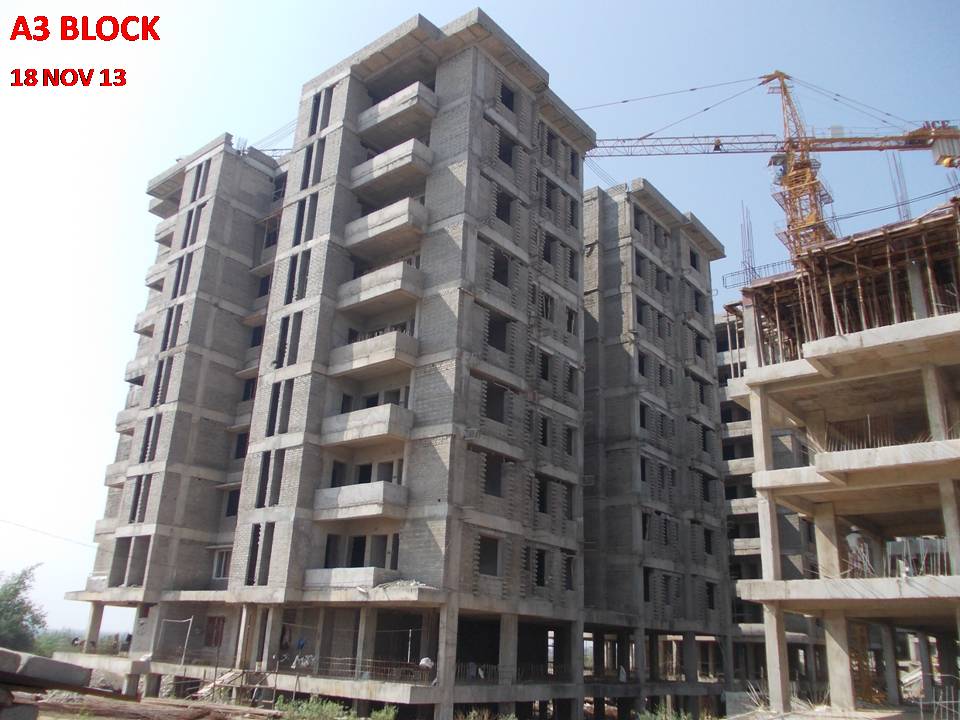

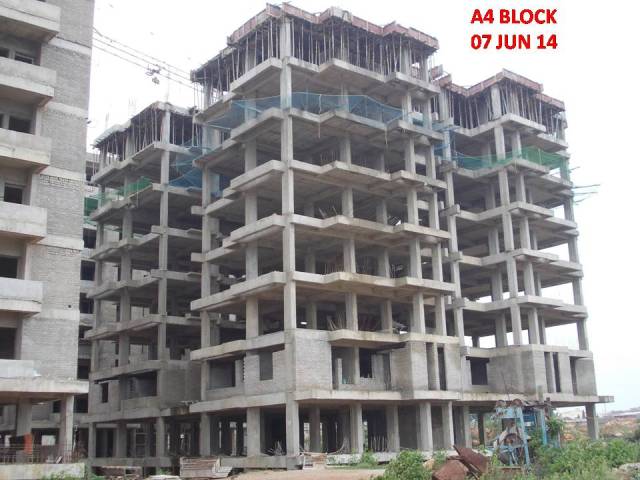

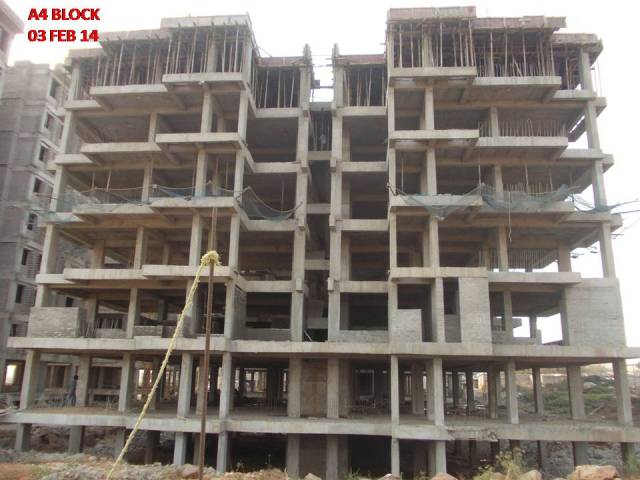

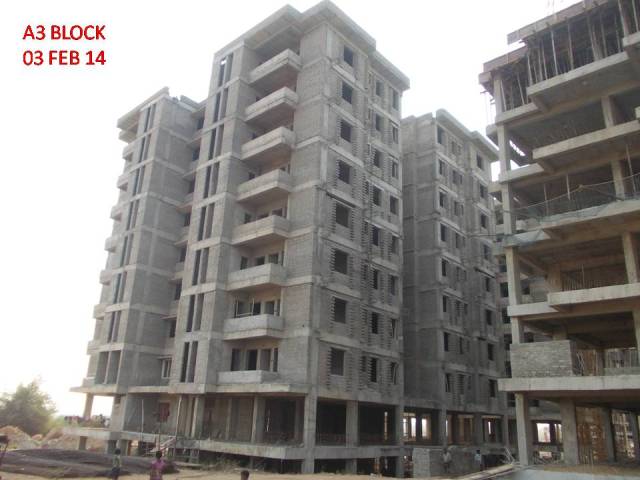

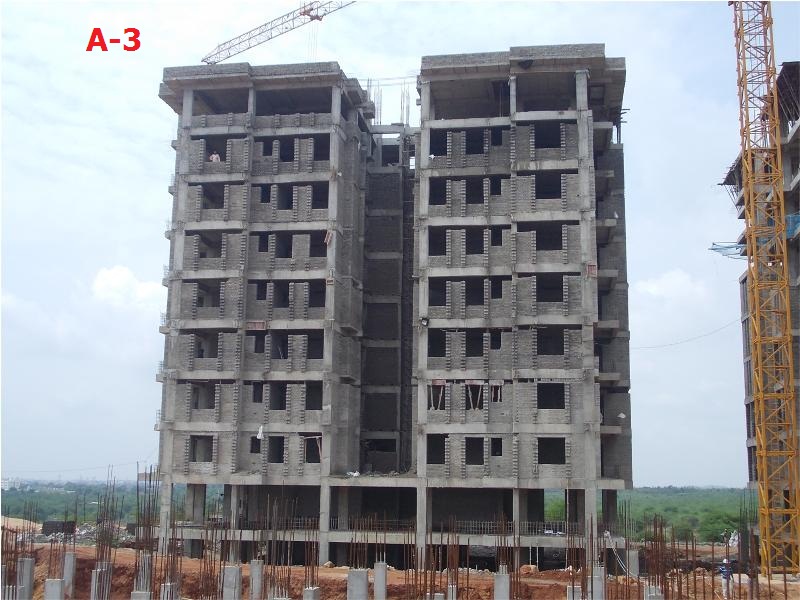

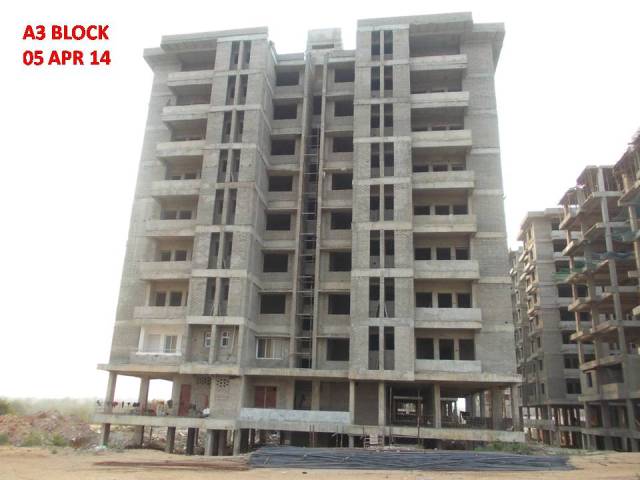

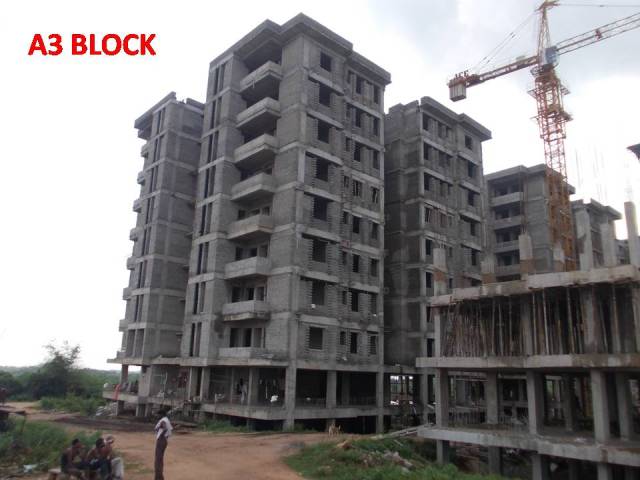

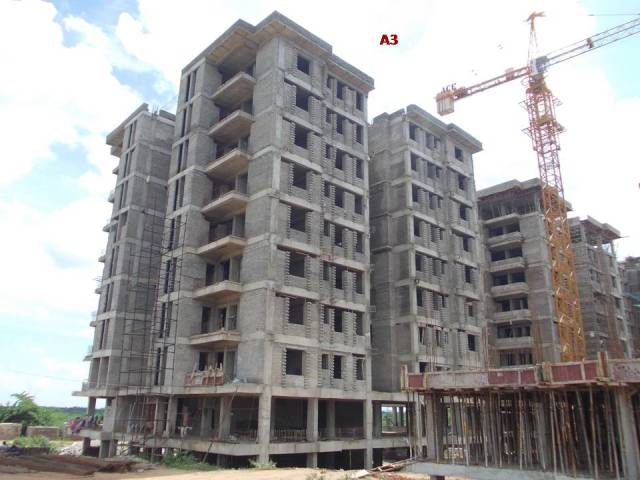

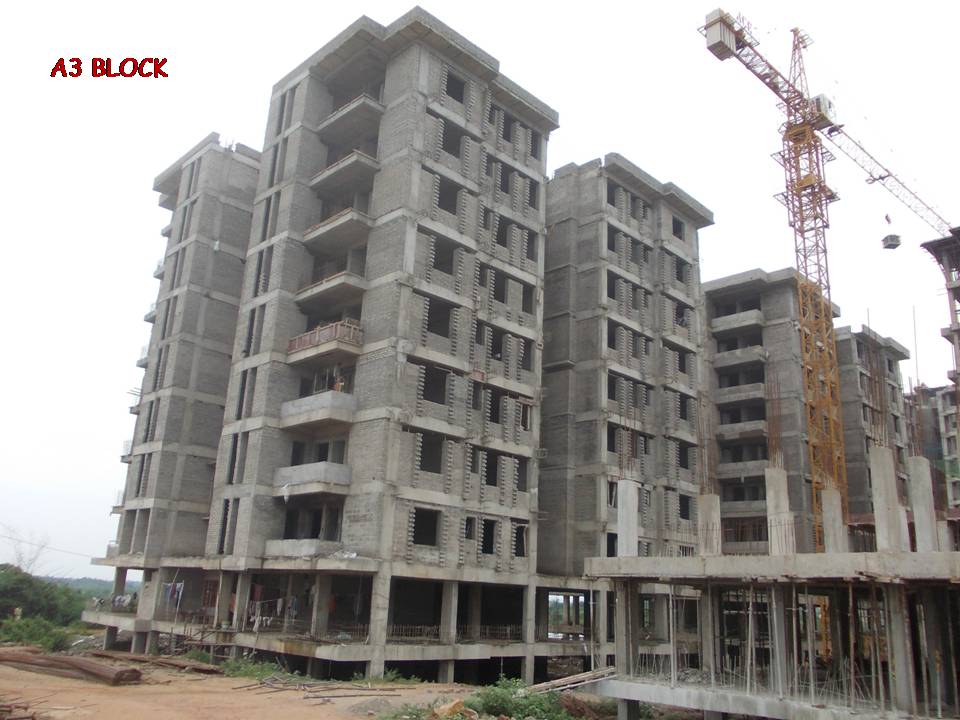

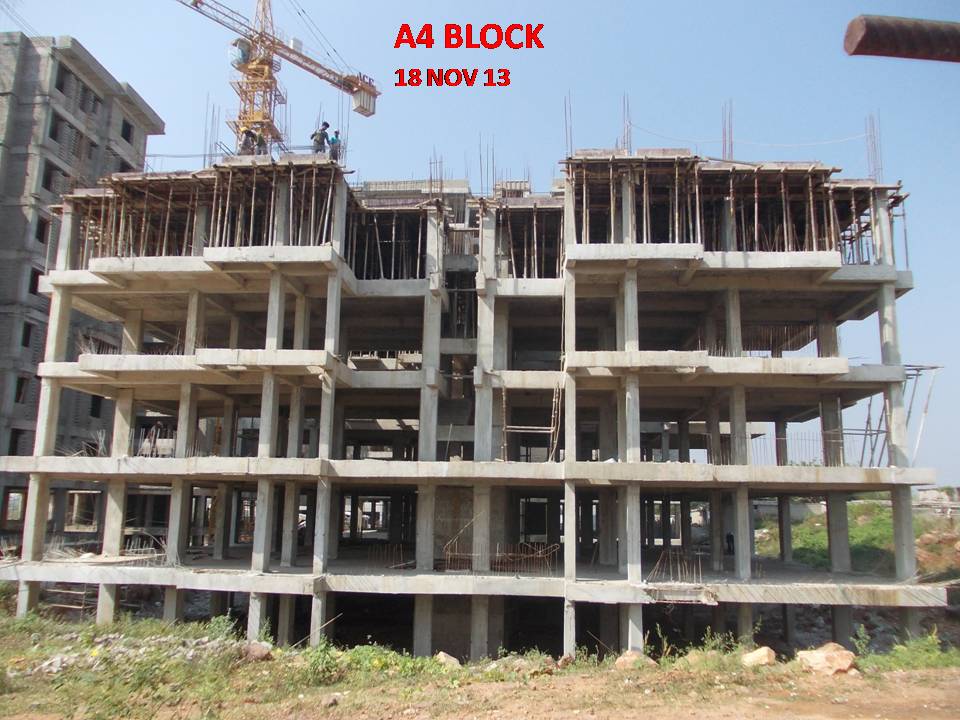

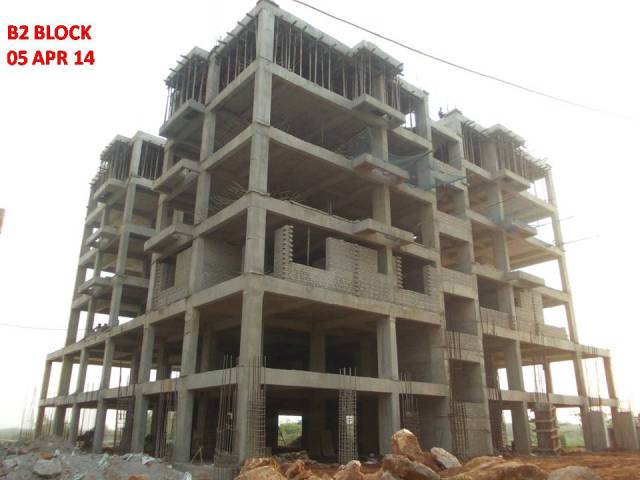

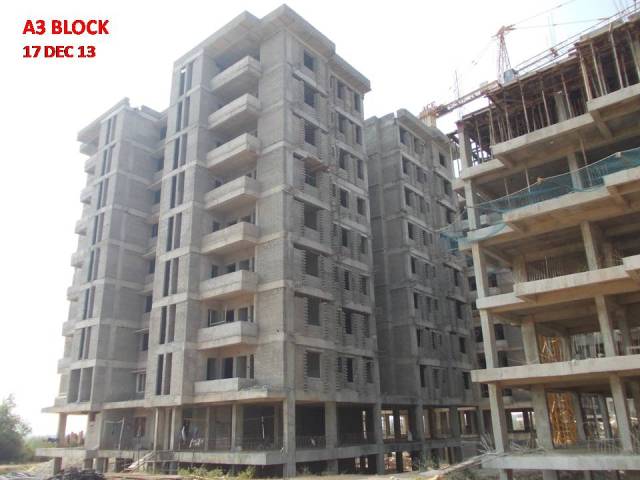

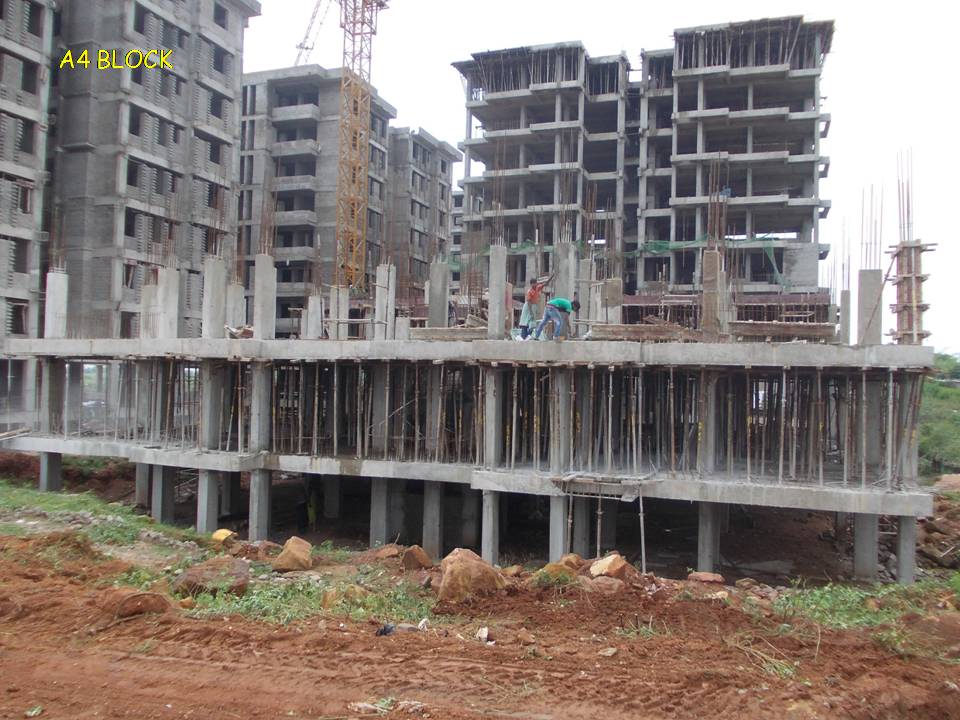

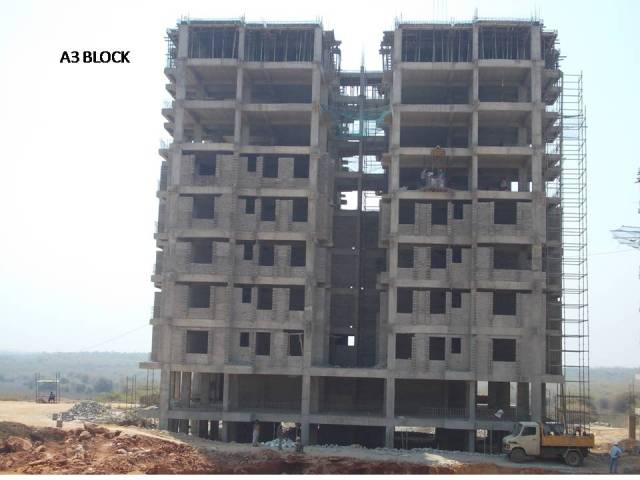

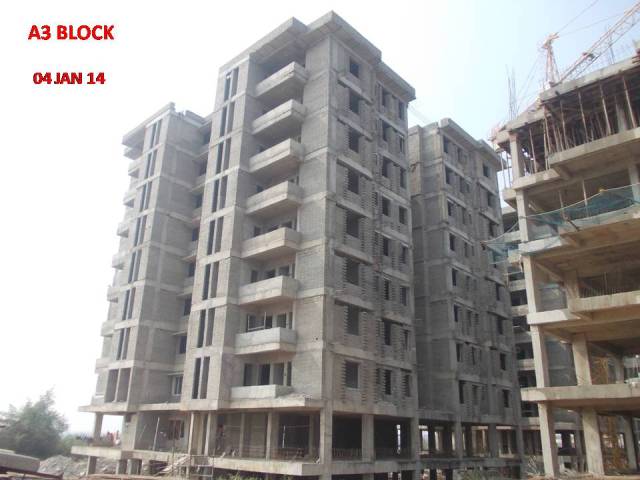

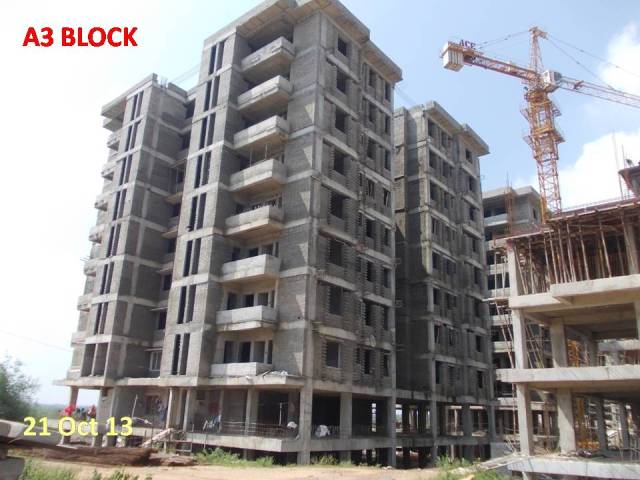

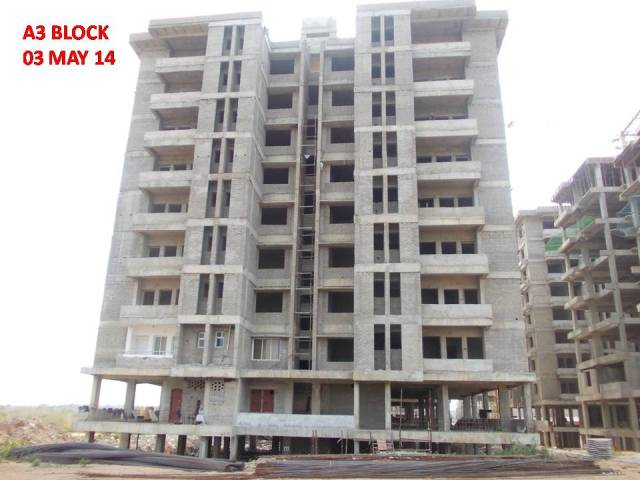

  • Footing work of A-3 block started.

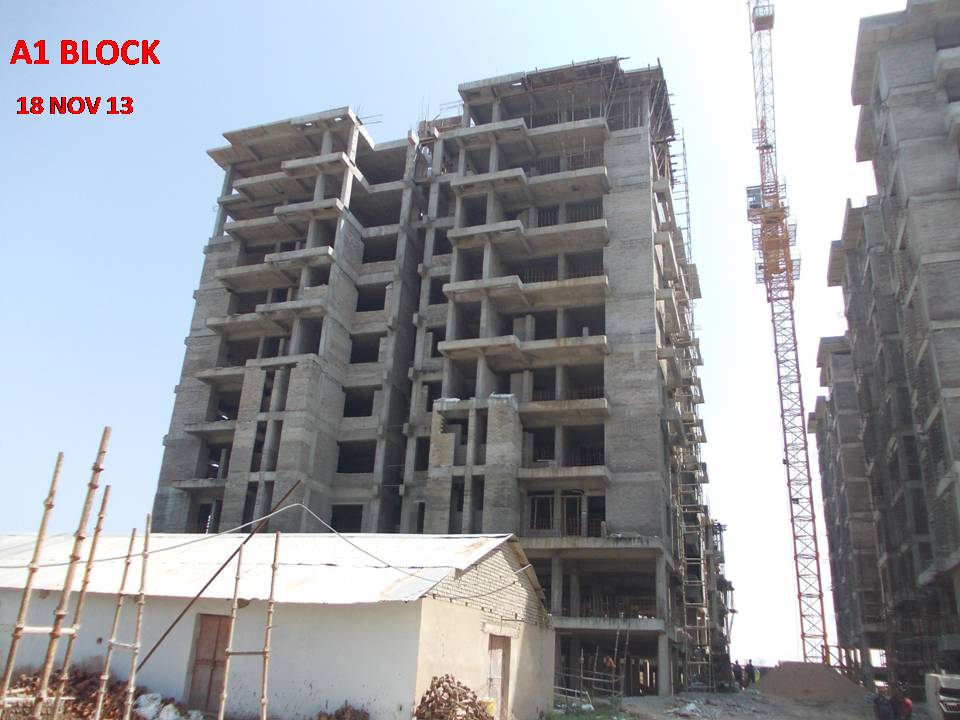

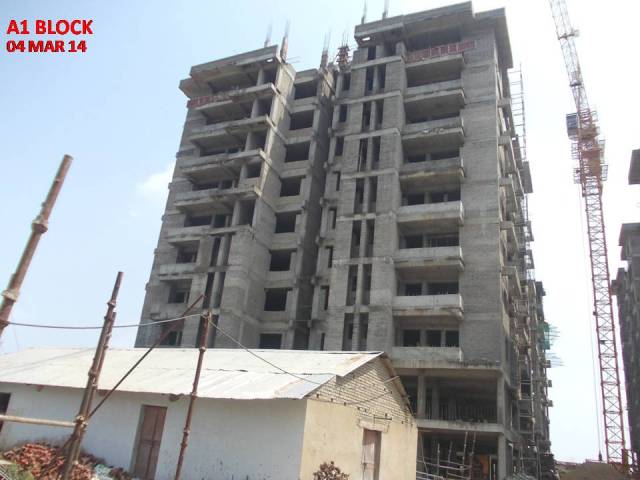

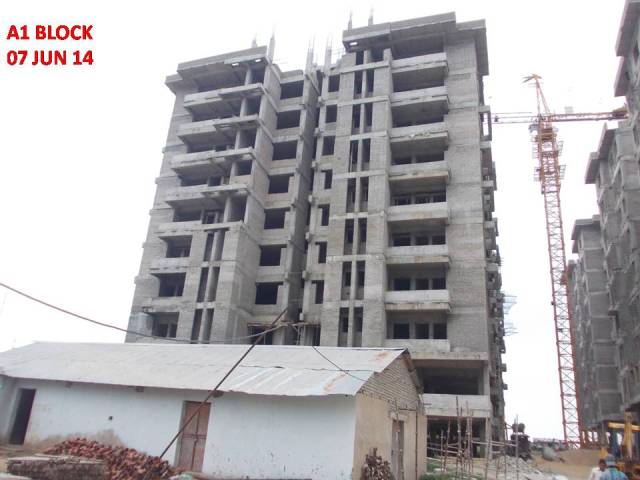

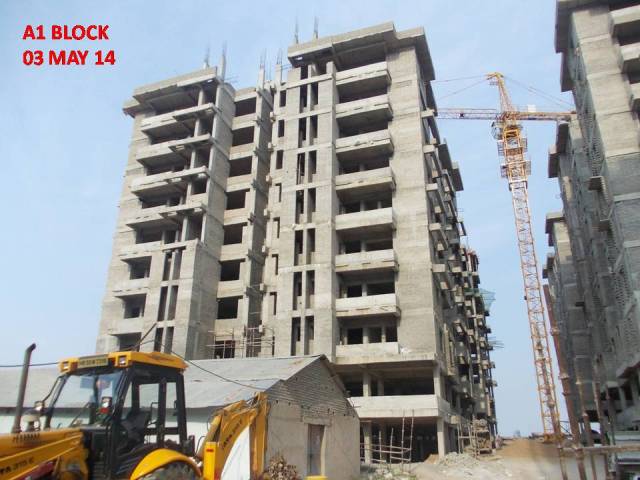

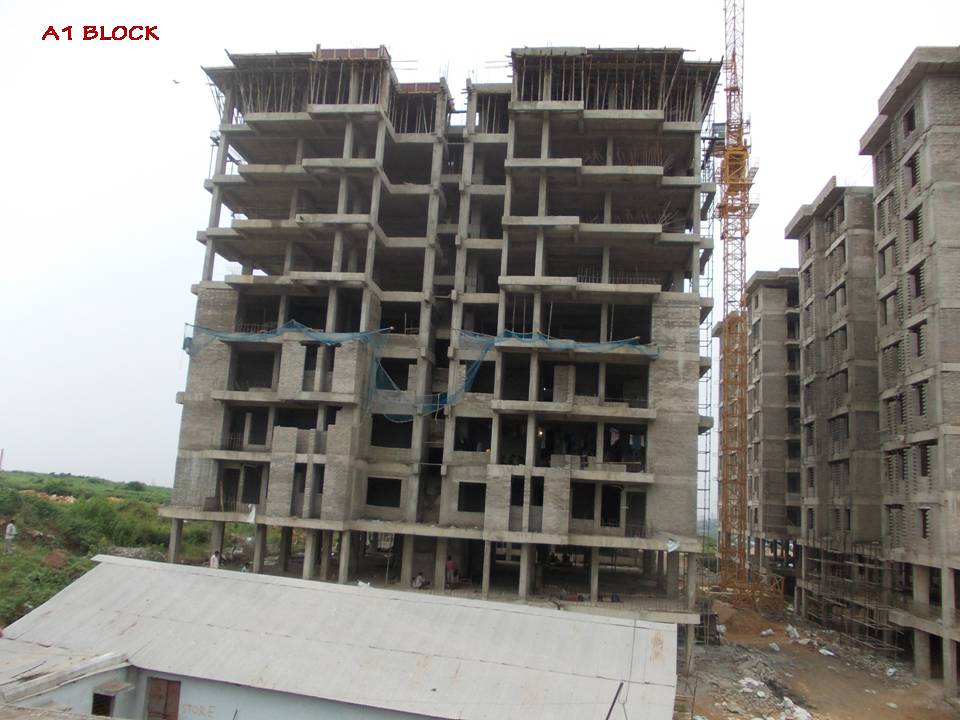

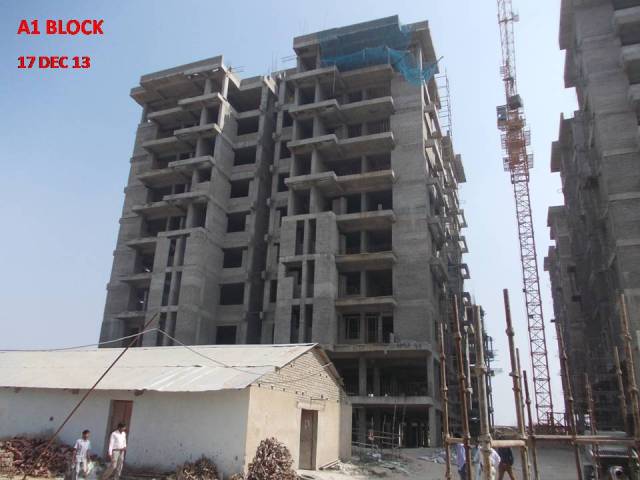

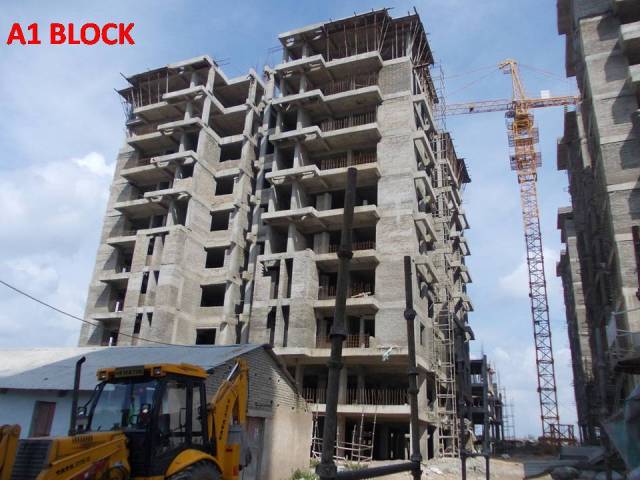

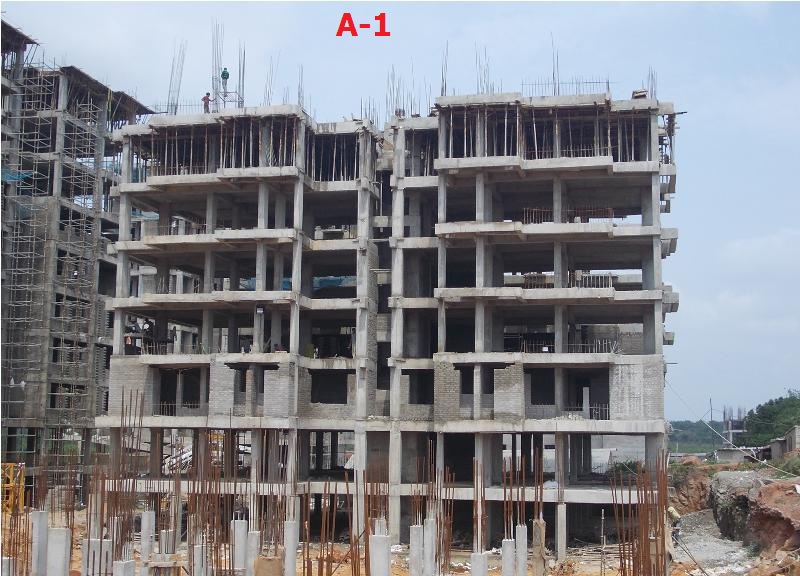

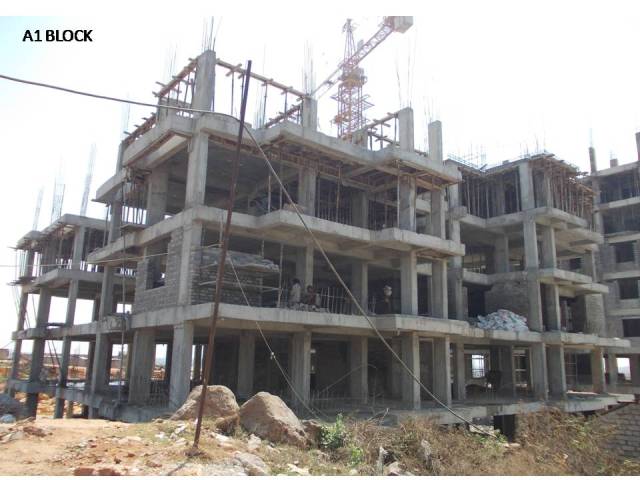

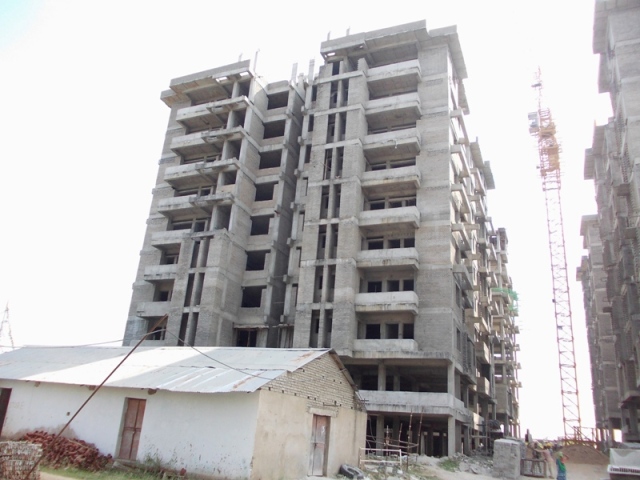

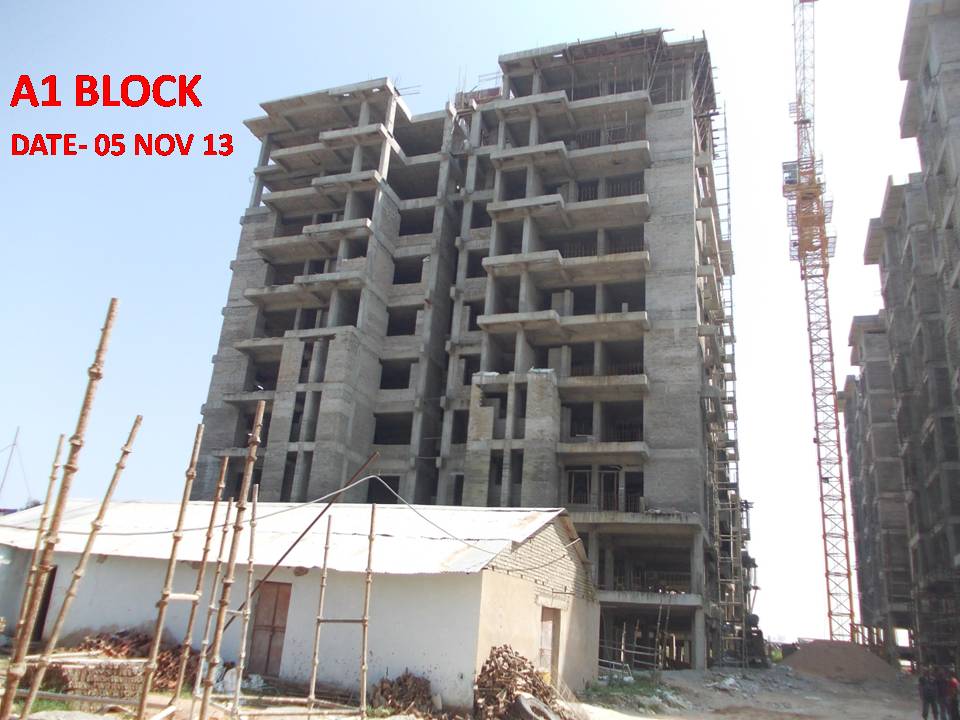

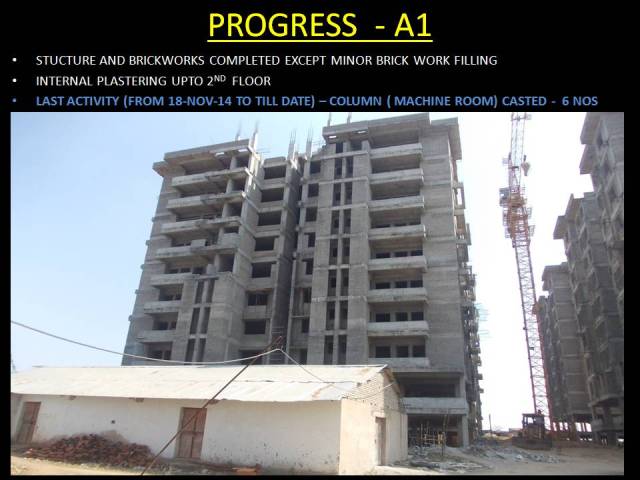

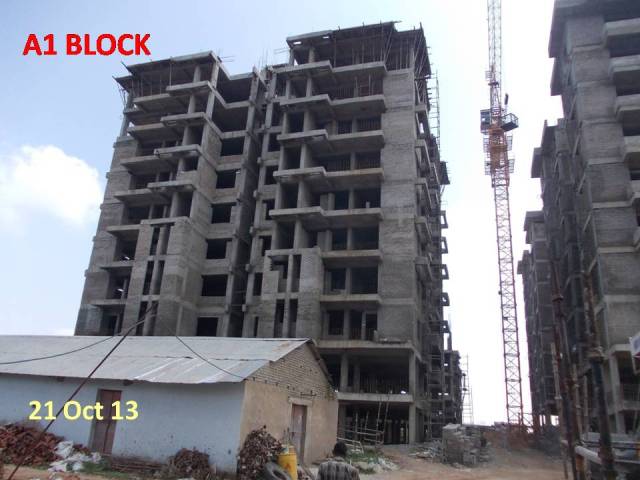

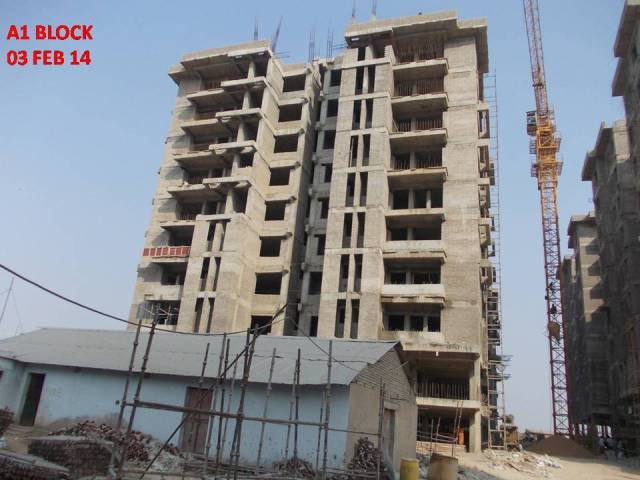

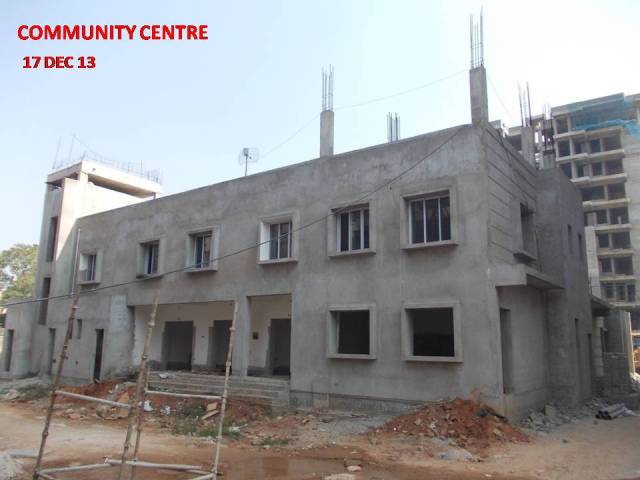

  • Excavation of A-1 block on the verge of completion.
  • The project is Two months behind schedule mainly due to the pipeline passing through B1 and B2 blocks and incessant rains in July and August.
  • Click on http://wikimapia.org/#lat=20.3218052&lon=85.8028471&z=18&l=0&m=b for seeing the site location on Wikimapia.

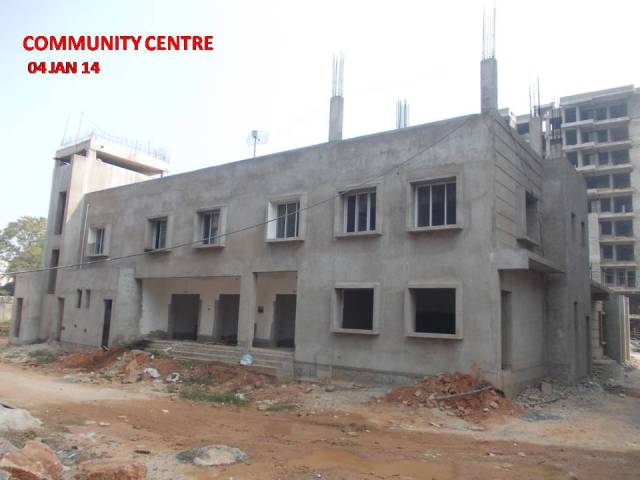

    SITE LAYOUT PLAN
    TENTATIVE COST, AREA AND ACCOMMODATION
    Type
    Super Area (Tentative)
    No of DU
    Tentative Cost (Lacs) Tentative Accommodation
    Officers (Type A) 1506 Sq Ft
    128
    30.16*
    Drawing/Dining Room, 3 Bedrooms, Kitchen, 2 Toilets, Utility and Balcony.
    Airmen/ Sailors (Type B)
    1155 Sq Ft
    128
    23.13*
    Drawing/Dining Room, 2 Bedrooms, Kitchen, 2 Toilets, and Balconies.
    * Post award of civil contract.
    INSTALMENT PLAN (Rs.)
    Instalment
    Category
    Due Date

    A
    B

    Registration Fee
    1,01,000
    51,000
    10 Dec 2010
    First
    4,50,000
    3,50,000
    08 Aug 2011
    Second
    4,50,000
    3,50,000
    10 Jan 2012
    Third
    4,50,000
    3,50,000
    10 Apr 2012
    Further Installment
    Will be intimated separately
